Introduction
Payment disputes rank among the most disruptive problems contractors, subcontractors, and suppliers face on California construction projects. A single unpaid invoice can freeze payroll, delay material orders, and strain relationships built over years.
These conflicts rarely appear out of nowhere. They start with scope changes nobody wrote down, quality disagreements over a punch list, payment terms buried in fine print, or an invoice that simply never gets paid.
According to Arcadis's 2025 Construction Disputes Report, the average North American construction dispute in 2024 involved $60.1 million and took 12.5 months to resolve.
Most payment disputes can be resolved without ever seeing a courtroom, provided you diagnose the problem correctly and act within California's tight legal deadlines.
This article covers the common causes, a step-by-step resolution process, how to choose between negotiation, mediation, arbitration, or litigation, and when it's time to call a construction attorney.
Key Takeaways
- Scope creep, quality disputes, retention delays, and late payments cause most disputes
- Careful documentation and a defined process resolve most disputes before litigation starts
- Resolution options range from a phone call to lien enforcement, each with different cost tradeoffs
- California lien and stop notice deadlines are strict, and missing one forfeits payment rights
What Is a Construction Payment Dispute?
A construction payment dispute is a disagreement between project parties, whether owner, general contractor, subcontractor, or supplier, over whether payment is owed, how much, or when it's due. It sounds simple. In practice, it rarely is.
Money on a construction project moves through a chain: the owner pays the general contractor, who pays subcontractors, who pay their own suppliers and lower-tier trades. A break anywhere in that chain can trigger a dispute that ripples downstream through every tier below it.
An owner withholding payment from a GC over a quality complaint can leave subcontractors unpaid for work completed weeks earlier, even though they had nothing to do with the alleged defect.
This structure makes payment disputes a predictable risk of how construction financing works, not an occasional anomaly. Controlling that risk requires:
- Clear contract language defining payment triggers and timelines
- Documentation habits that capture scope changes, approvals, and correspondence as they happen
- Familiarity with statutory protections like mechanic's liens and stop payment notices, which exist precisely because this payment chain breaks down so often
Treating payment disputes as foreseeable, rather than surprising, changes how you prepare for them, and that preparation often determines whether a dispute resolves in days or drags on for months.
Common Causes of Construction Payment Disputes
Most payment disputes on California projects fall into a handful of recurring patterns. They tend to trace back to contract ambiguity, gaps in documentation, or differing interpretations of what work was actually performed and approved.
Scope Creep and Change Order Disputes
Additional work gets performed without a signed change order, and when the invoice arrives, nobody agrees on who owes what.
- How it shows up: A superintendent verbally approves extra work, but no written change order follows
- Root cause: Informal approvals and missing documentation of the expanded scope
Withheld Payment Over Alleged Defects or Quality Issues
An owner or GC holds back part or all of an invoice, citing incomplete or substandard work.
- What it looks like: Payment is withheld with little detail about what's wrong or how to fix it
- Why it happens: No punch-list or inspection process was agreed upon before payment terms were set
Retention and Final Payment Disputes
Retention funds sit unpaid long after substantial completion, with no release date in sight.
- How it shows up: Retention is withheld indefinitely, sometimes months past project completion
- Why it happens: The contract lacks a defined retention release trigger or timeline
Under California Civil Code section 8812, an owner generally must pay retention to the direct contractor within 45 days of completion. Section 8814 then requires the contractor to pass that retention to subcontractors within 10 days of receiving it. Many contracts simply don't reflect these statutory timelines, which fuels confusion when retention lingers unpaid.
Late or Non-Payment Disputes
Invoices go unpaid past their due date with no explanation, or partial payments arrive without notice of what's being withheld.
- What it looks like: A subcontractor sends repeated follow-ups and gets no response
- Root cause: Cash flow problems upstream, pay-if-paid or pay-when-paid clauses, or intentional stalling

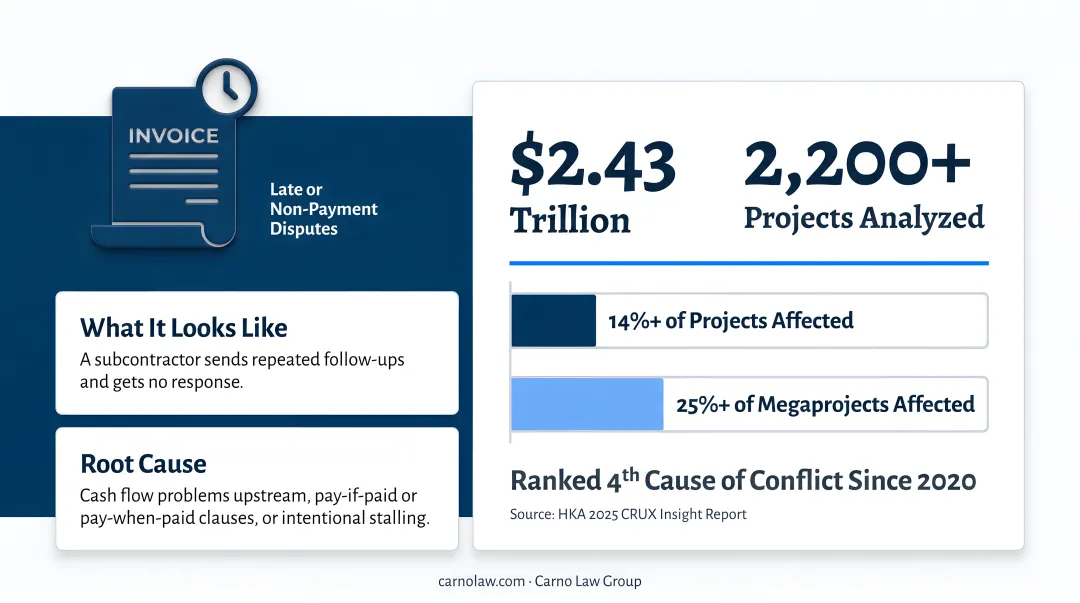

These four patterns show up on California jobsites again and again, and the numbers back that up. HKA's 2025 CRUX Insight report analyzed more than 2,200 projects worth a combined $2.43 trillion. Cash-flow and payment problems ranked fourth among causes of conflict on projects started after 2020, affecting more than 14% of projects and over 25% of megaprojects.

How to Resolve a Construction Payment Dispute: Step-by-Step
Trying to resolve a payment dispute before pinning down its exact nature almost always backfires. You waste time chasing the wrong remedy, damage a relationship that didn't need damaging, or miss a legal deadline that can't be recovered. The steps below help you diagnose the dispute correctly and match it to the right resolution strategy.
Step 1: Document and Define the Exact Dispute
Start by pulling together everything relevant:
- The contract and any amendments
- Change orders, signed or unsigned
- Invoices and payment records
- Written correspondence about the disputed amount
Then get specific. Is the dispute about the amount owed, the timing, the quality of work, or the scope? Note any deadlines already running. Notice periods and lien filing windows under California law don't pause while you're trying to sort things out informally.
Step 2: Identify the Root Cause Category
Determine whether the dispute stems from a contract interpretation disagreement, a documentation gap, a quality or performance issue, or a cash flow problem upstream. Review the specific clauses at issue, including payment terms, change order procedures, retention language, and any pay-if-paid or pay-when-paid provisions.
Applying the wrong resolution strategy to the wrong root cause is one of the most common ways disputes drag on longer than necessary and expose everyone to added legal risk.
Step 3: Apply the Resolution Strategy That Matches the Dispute Type
The right approach depends entirely on what's actually driving the non-payment.
If it's late or non-payment:
- Send a formal written demand letter referencing the contract and amount owed
- Consider California's prompt payment statutes, which cap good-faith withholding at 150% of the disputed amount and impose 2% monthly penalties for wrongful withholding
- Evaluate whether a mechanic's lien or stop payment notice should be filed before deadlines expire
If it's withheld payment for alleged defects:
- Request an itemized list of the alleged deficiencies in writing
- Offer to cure the issues, or propose a third-party inspection to settle the disagreement objectively
- Negotiate a partial release of the undisputed amount while the defect claim is resolved separately
If it's a scope or change order disagreement:
- Present documentation supporting the extra work and its agreed or implied value
- Submit a formal change order claim referencing the contract's scope-modification provisions
- Reference industry-standard pricing or a third-party expert opinion if the added scope's value remains contested
If it's contract language or a pay-if-paid clause:
- Have a construction attorney, such as those at Carno Law Group, review the clause's enforceability, since California courts scrutinize these provisions closely
- Note that the California Supreme Court's ruling in Wm. R. Clarke Corp. v. Safeco Ins. Co. found a true pay-if-paid condition unenforceable because it improperly shifted the owner's nonpayment risk onto the subcontractor
- Determine whether the clause creates an unreasonable or indefinite delay in payment, which courts have also rejected

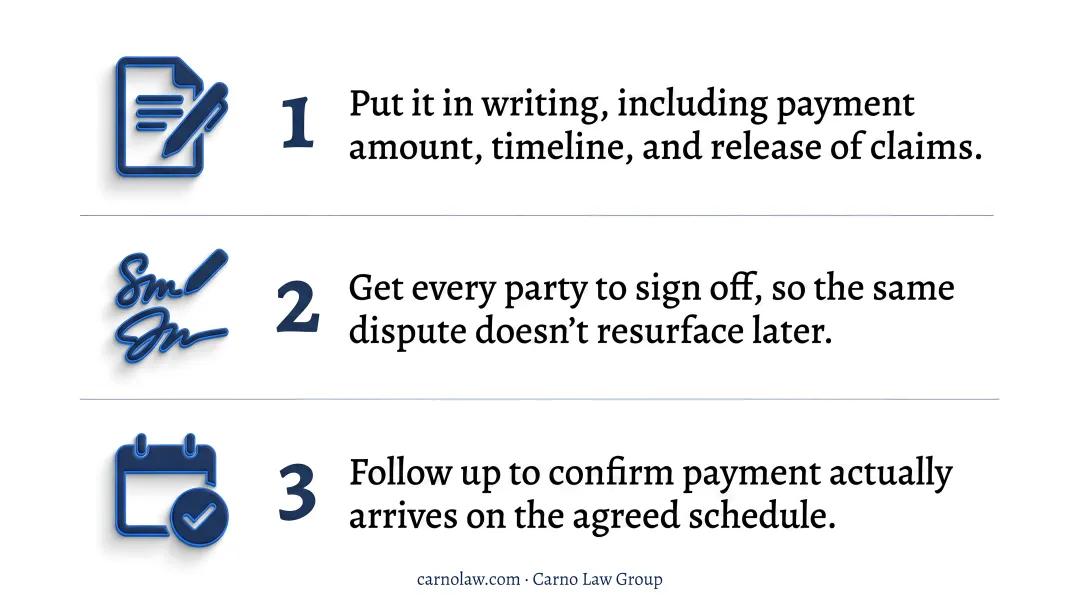

Step 4: Formalize and Confirm the Resolution
Once you reach an agreement:
- Put it in writing, including payment amount, timeline, and release of claims
- Get every party to sign off, so the same dispute doesn't resurface later
- Follow up to confirm payment actually arrives on the agreed schedule

Negotiation, Mediation, Arbitration, or Litigation: Choosing the Right Path
Each path trades off cost, speed, and impact on the business relationship differently. Picking the right one from the outset can save significant money and months of frustration.
When the Dispute Is Small and the Relationship Matters
Negotiate directly, then document the resolution in writing. Mediation and litigation costs can easily exceed the disputed amount on a smaller invoice, making direct negotiation the only option that makes financial sense.
When the Contract Requires ADR or the Relationship Is Worth Preserving
Mediation puts a neutral third party in the room to help both sides reach a mutually acceptable outcome. It's non-binding unless you sign a settlement agreement, keeping control in the parties' hands rather than an arbitrator's.
According to American Arbitration Association FY2025 data, mediation filings across practice areas carried a 112-day median timeline, notably faster than arbitration or litigation.
When the Contract Has a Binding Arbitration Clause
Arbitration produces a binding decision with limited appeal rights, so prepare evidence with the same seriousness as litigation. It isn't necessarily quick, either: AAA's FY2025 construction data shows a 17-month median time to award overall, stretching to 20.5 months for claims of $1 million or more.
When Lien Rights, Large Sums, or Deadlines Are at Risk

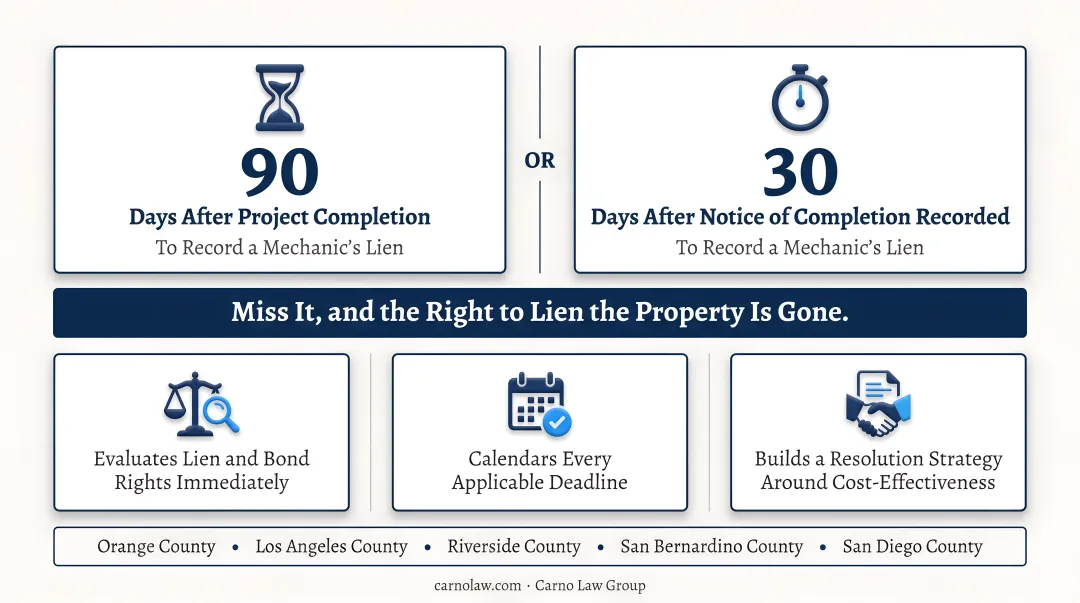

This is where speed matters most. California's lien and stop notice deadlines are unforgiving. A subcontractor generally has 90 days after project completion, or 30 days after a notice of completion is recorded, to record a mechanic's lien. Miss it, and the right to lien the property is gone.
When that much is on the line, waiting to "see how things play out" is the costliest mistake you can make. Bringing in an experienced construction litigation firm early matters most in these situations.

Carno Law Group works with contractors, subcontractors, and suppliers across Orange, Los Angeles, Riverside, San Bernardino, and San Diego Counties. The firm evaluates lien and bond rights immediately, calendars every applicable deadline, and builds a resolution strategy around cost-effectiveness rather than reflexive litigation.
Common Mistakes and How to Prevent Future Disputes
Common Mistakes to Avoid
- Withholding or demanding payment without documenting the reason in writing
- Missing statutory notice or lien filing deadlines while waiting for informal resolution to work
- Relying on generic or vague contract templates that skip payment schedules, retention terms, or dispute procedures entirely
Preventive Measures for Future Projects
Avoiding these mistakes starts with building safeguards into every project from day one:
- Use detailed contracts with specific payment schedules, retention release triggers, and dispute resolution clauses drafted or reviewed by a construction attorney to hold up in California courts.
- Keep thorough documentation throughout the project: change orders, daily logs, photos, and written correspondence, filed as you go rather than reconstructed after a dispute starts.
- Know and calendar every lien, stop notice, and bond claim deadline that applies before work even begins.
Carno Law Group's contract drafting practice focuses on exactly this kind of prevention. The firm builds payment terms, retention triggers, and ADR clauses into contracts from the first draft, calibrated to California's mechanic's lien and indemnity statutes rather than borrowed from an out-of-state template.
Frequently Asked Questions
How do I resolve payment disputes in construction?
Document the exact issue, identify its root cause, then apply the matching strategy, whether negotiation, mediation, arbitration, or lien enforcement, escalating only as needed.
What is the most common payment dispute in construction?
Disputes over scope changes and change orders, along with withheld payments for alleged quality issues, are among the most frequent, often made worse by unclear contract payment terms.
What are the types of disputes in construction?
The main categories are payment disputes, scope and change order disputes, delay claims, and defect or quality disputes. Payment issues frequently overlap with the other three.
Do I need a lawyer for a construction payment dispute?
Legal counsel becomes important when significant money is at stake, a lien deadline is approaching, or the other party disputes contract terms or alleges defective work. Carno Law Group offers a free initial consultation to help you assess whether legal action is the right next step.
How long does it take to resolve a construction payment dispute?
Timelines vary widely. Negotiation can resolve a dispute in days, mediation and arbitration typically take weeks to over a year, and litigation can extend beyond a year.
Can a contractor stop work over a payment dispute?
Stopping work may be allowed under specific contract clauses or California prompt payment laws, but doing so without proper notice can create legal exposure. Review your contract terms first.
