According to Rabbet's 2024 Construction Payments Report, slow payments cost the U.S. construction industry $280 billion in 2024, with 82% of contractors reporting payment delays exceeding 30 days. For California contractors, the stakes are even higher: the state's lien law, bond law, and prompt payment statutes create powerful recovery tools — but only for those who follow the required procedures from day one.
This guide walks through the complete payment dispute resolution process for California contractors, subcontractors, haulers, and material and equipment suppliers — from preliminary notice through legal enforcement.
Key Takeaways
- Mechanic's liens, stop notices, and bond claims require a timely 20-day preliminary notice — no notice, no recovery
- The dispute resolution process escalates: documentation → formal demand → ADR → legal enforcement
- After a recorded notice of completion, subcontractors and suppliers have 30 days to record a lien — not 60
- Missing a single statutory deadline can permanently eliminate an otherwise valid payment claim
- Early attorney involvement costs far less than forfeiting lien rights after a missed deadline
What Is the Construction Payment Dispute Resolution Process?
Construction payment dispute resolution is the formal and informal process through which parties in a construction project address disagreements over amounts owed, payment timing, or refusal to pay for completed work or furnished materials.
It differs significantly from standard commercial invoice disputes. California construction payment claims are governed by a combination of:
- Contract law and express payment terms
- California's prompt payment statutes (Civil Code §8800 series; Public Contract Code §7107)
- Mechanic's lien law (Civil Code §8400 series)
- Stop payment notice law (Civil Code §8500 series; Civil Code §9350 series)
- Payment bond law under California's Little Miller Act (Civil Code §9550 series)
That combination makes construction payment disputes deadline-driven in ways that standard commercial disputes are not. Miss a filing window, and a valid claim can become unenforceable, regardless of how much work you completed or how clearly you were wronged.
Who's Involved in the Payment Chain
The standard construction payment chain runs: owner/developer → general contractor → subcontractors → material and equipment suppliers. Payment problems at any level can cascade downward, affecting parties who performed their work properly.
One important California distinction: pay-if-paid clauses are unenforceable. These clauses attempt to make a subcontractor's right to payment conditional on the owner paying the GC first. The California Supreme Court held in Wm. R. Clarke Corp. v. Safeco Ins. Co. that such clauses impermissibly waive subcontractors' mechanic's lien rights.
Pay-when-paid clauses are treated differently — as timing provisions rather than absolute bars to payment.

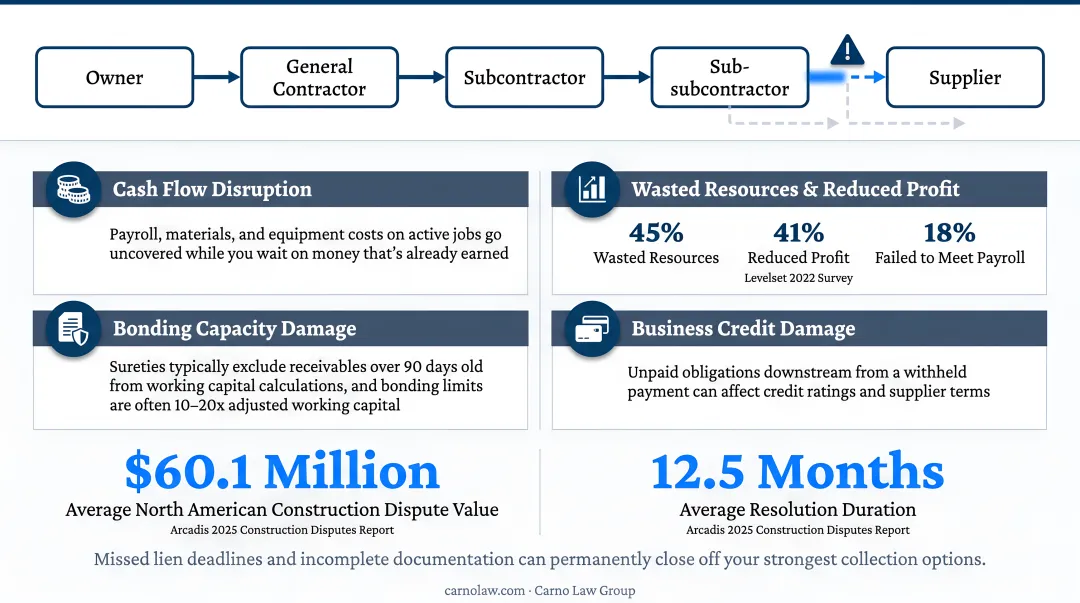

Why Construction Payment Disputes Are So Costly
The tiered payment chain means a dispute or default at one level can trigger non-payment throughout the entire chain — even for parties who had nothing to do with the underlying problem.
The consequences reach beyond a single unpaid invoice:
- Cash flow disruption — payroll, materials, and equipment costs on active jobs go uncovered while you wait on money that's already earned
- Wasted resources and reduced profit — Levelset's 2022 survey found slow payments contributed to wasted resources (45%), reduced profit (41%), and failure to meet payroll (18%)
- Bonding capacity damage — sureties typically exclude receivables over 90 days old from working capital calculations, and bonding limits are often 10–20x adjusted working capital, meaning one large unpaid receivable can cut future bonding capacity substantially
- Business credit damage — unpaid obligations downstream from a withheld payment can affect credit ratings and supplier terms

The Arcadis 2025 Construction Disputes Report pegged the average North American construction dispute value at $60.1 million, with an average resolution duration of 12.5 months. Even disputes a fraction of that size routinely lock up cash for 12 months or more — time during which missed lien deadlines and incomplete documentation can permanently close off your strongest collection options.
How the Construction Payment Dispute Resolution Process Works
The process follows an escalating structure. Certain legal rights must be preserved through proactive notice actions from the very beginning of a project — before any dispute arises — which is what makes construction payment law different from almost every other type of commercial dispute.

Step 1: Send Preliminary Notice
This is where most contractors lose before the dispute even begins.
California Civil Code §8200 makes preliminary notice a prerequisite to the validity of a mechanic's lien, stop payment notice, or payment bond claim. Under Civil Code §8204, notice must be given within 20 days of first furnishing labor, services, or materials.
Key points:
- Recipients: the owner or reputed owner, the direct contractor or reputed direct contractor, and the construction lender (if any)
- Late notice: if sent after 20 days, it preserves rights only for work provided within the 20 days before notice and work performed after notice — everything earlier is lost
- Exemptions: laborers are exempt; claimants with a direct contract with the owner need only notify the construction lender, if any
- Not a threat: preliminary notice is a statutory requirement, not an accusation — it simply preserves future rights

Miss this deadline and no other step in this guide can recover what you've lost.
Step 2: Document the Dispute and Issue a Formal Demand
When payment is withheld, gather everything before making contact:
- Signed contract and all executed change orders
- Invoices and delivery receipts
- Lien waivers exchanged (conditional vs. unconditional)
- All written correspondence, including texts and emails
- Any stop work notices or notices of default
Then issue a formal written demand identifying the specific amount owed, the contractual or statutory basis for the claim, and a clear response deadline. Written demand creates a record, establishes the dispute timeline, and often prompts payment before legal remedies become necessary.
Step 3: Attempt Negotiation or Alternative Dispute Resolution
Direct negotiation between the parties — or structured ADR through mediation or arbitration — resolves most construction payment disputes faster and at lower cost than litigation. AAA data shows construction mediation filings have a median settlement duration of 112 days, and arbitration in smaller disputes closes roughly 3x faster than reaching trial in federal court.
Before escalating, check your contract. Many construction contracts contain mandatory mediation or arbitration clauses that must be exhausted before filing suit. Skipping that step can waive rights or draw a motion to compel arbitration that stalls your case entirely.
Step 4: Enforce Legal Remedies
When negotiation and ADR don't resolve the dispute, California law provides three statutory enforcement tools — each with strict deadlines:
| Tool | Applies To | Key Deadline |
|---|---|---|
| Mechanic's Lien | Private works | 30–90 days after completion or notice of completion |
| Stop Payment Notice | Public and private works | 30–90 days after completion or notice of completion |
| Payment Bond Claim | Public works | Notice within 15–75 days after completion |

Each tool is addressed in detail in the next section.

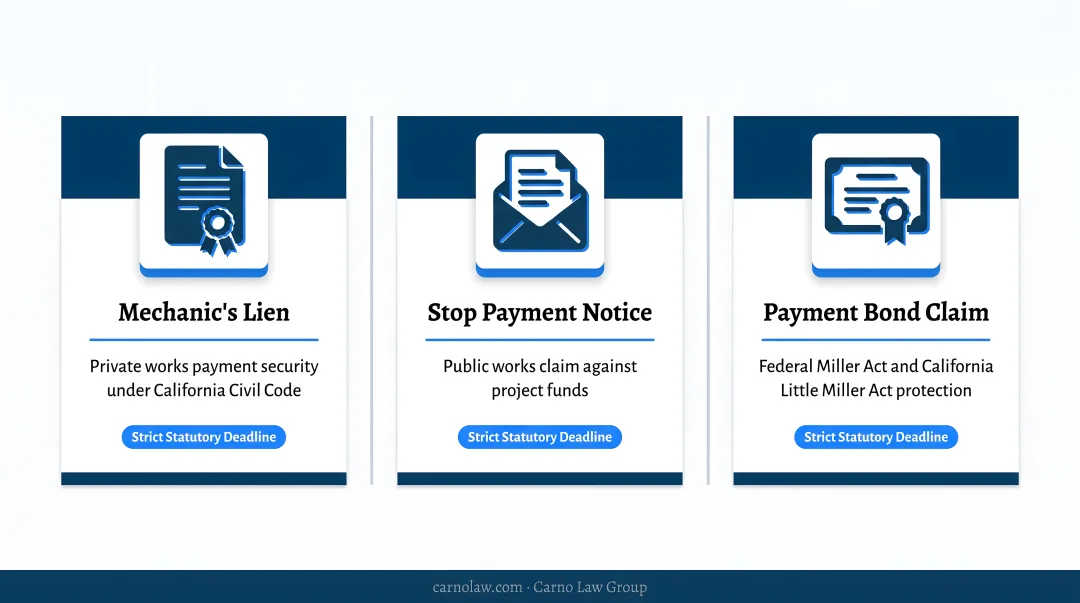

Legal Tools Available to Contractors and Suppliers
California's construction payment laws offer some of the strongest protections for unpaid contractors and suppliers in the country — but they are available only to those who followed the required procedures.
Mechanic's Liens
A mechanic's lien is recorded against the private property where work was performed. It clouds title and gives the claimant the right to force a sale of the property to satisfy the debt.
Recording deadlines under the Civil Code §8400 series:
- Direct contractors (Civil Code §8412): record within 90 days after project completion, or within 60 days after the owner records a notice of completion or cessation — whichever is earlier
- Subcontractors and suppliers (Civil Code §8414): record within 90 days after completion, or within 30 days after a recorded notice of completion or cessation — whichever is earlier
This distinction matters. Subcontractors and suppliers have only 30 days after a recorded notice of completion — not 60. Many claimants miss this deadline because they assume the direct contractor's 60-day window applies to them.
After recording, the claimant must file a foreclosure lawsuit within 90 days of recording. Under Civil Code §8460, the lien expires and is unenforceable if suit is not filed within that window.
Stop Payment Notices
A stop payment notice requires a construction lender or public agency to withhold funds from the general contractor equal to the claim amount. It targets undisbursed funds, not property.
Stop payment notices are most effective:
- On public works, where mechanic's liens cannot attach to public property
- On lender-financed private projects, where the notice targets the construction loan fund
- When lien rights were not fully preserved but construction funds remain in the pipeline
Public stop payment notices (Civil Code §9350 et seq.) must be given within 30 days after recordation of a notice of completion or acceptance, or within 90 days after cessation or completion if no notice is recorded.
Bond Claims
On California public works contracts involving expenditures over $25,000, general contractors must obtain a payment bond under Civil Code §9550. Subcontractors and suppliers who are not paid have a direct claim against that bond.
This is the primary payment recovery mechanism on public projects — liens against public property are prohibited under California law.
Key bond claim deadlines:
- Preliminary notice is required before asserting most bond claims (Civil Code §9300), with limited exceptions for laborers and those in direct contract with the general contractor
- If preliminary notice was not sent, certain claimants may still preserve a bond claim by giving written notice to the surety and principal within 15 days after a recorded notice of completion, or 75 days after completion if no notice is recorded (Civil Code §9560)
- A lawsuit on a public works payment bond must be filed within six months after the period in which stop payment notices may be given (Civil Code §9564)
California Prompt Payment Laws
California imposes specific payment timelines and penalties on owners, general contractors, and public agencies that pay late:
- Private progress payments (Civil Code §8800): owners must pay direct contractors within 30 days of demand; violations carry a 2% per month penalty plus prevailing-party fees
- Contractor-to-subcontractor payments (B&P Code §7108.5): prime contractors must pay subcontractors within 7 days of receiving a progress payment; violations carry 2% per month penalty
- Public retention (Public Contract Code §7107): retention must be released within 60 days after completion; improperly withheld retention carries a 2% per month charge
These penalties can be pursued alongside lien and bond claims, increasing leverage during negotiations.

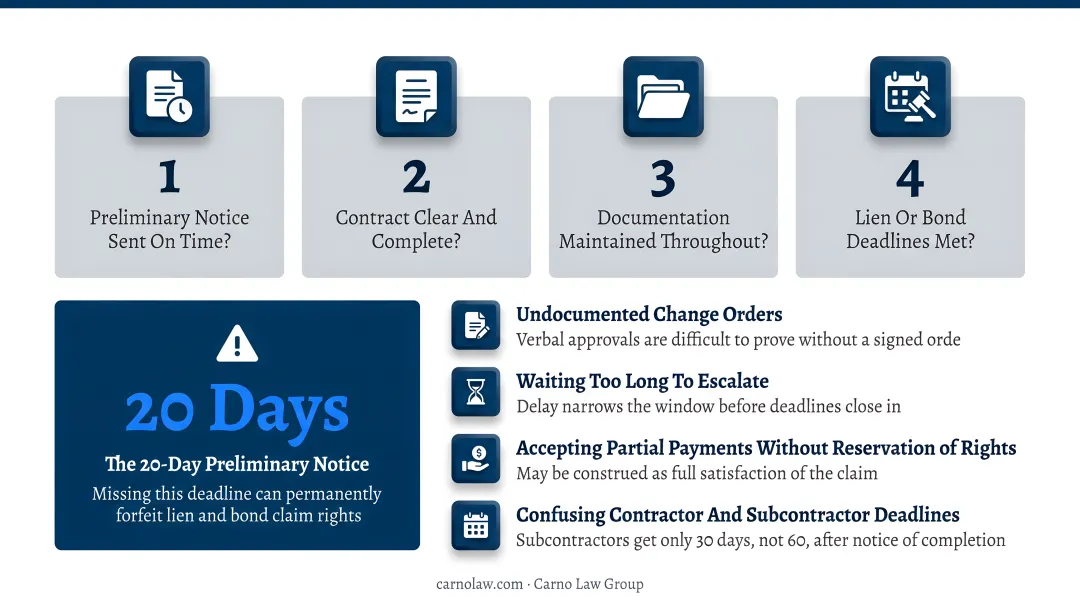

Key Factors and Common Mistakes
Whether a payment dispute can be successfully resolved often comes down to four factors:
- Was preliminary notice sent on time?
- Is the contract clear and complete?
- Was documentation maintained throughout the project?
- Were lien or bond deadlines met?
The most common and damaging mistake is failing to send the 20-day preliminary notice. Many contractors skip it on projects with established relationships, assuming trust substitutes for procedure. It doesn't. If notice wasn't sent, lien and bond claim rights may be permanently gone — regardless of how much work was completed or how clearly payment was earned.
Other mistakes that frequently undermine otherwise valid claims:
- Undocumented change orders: verbal approvals for extra work are difficult to prove; without a signed change order, scope additions become disputes about whether the work was authorized at all
- Waiting too long to escalate: the longer non-payment continues without formal action, the more lien and notice deadlines close in
- Accepting partial payments without reservation of rights language: a partial payment accepted without explicit reservation may be construed as satisfaction of the full claim
- Confusing direct contractor and subcontractor deadlines: subcontractors have only 30 days (not 60) after a recorded notice of completion to record a lien

What makes these mistakes compounding is that each one narrows your options. Miss the preliminary notice deadline and you've lost lien rights before the dispute even starts. Accept a partial payment without reservation language and you may have inadvertently closed the door on recovering the balance. When multiple steps are missed, the path to recovery shortens considerably — which is precisely when early legal counsel makes the biggest difference.
When to Seek Legal Counsel for a Construction Payment Dispute
Smaller disputes sometimes resolve with a formal demand letter and persistent follow-up. But involve a construction attorney as early as possible when:
- The disputed amount is significant enough to affect your business operations
- Lien or bond claim deadlines are approaching (or you are unsure whether notice was properly sent)
- The paying party has stopped responding to written communication
- The dispute involves a public works project or payment bond
- You received a check with "paid in full" language you didn't intend to accept
- There is any uncertainty about what notices have been properly preserved
Missing a single deadline — preliminary notice, lien recording, or foreclosure filing — can permanently extinguish an otherwise valid payment claim. Attorney involvement at the right moment costs far less than losing the right to recover at all.
That's where having the right firm in your corner matters. Carno Law Group represents contractors, subcontractors, haulers, and material and equipment providers throughout Orange, Los Angeles, Riverside, San Bernardino, and San Diego Counties. The firm handles mechanic's lien enforcement, stop payment notice claims, and bond claims on both private and public works projects, from initial notice through litigation when necessary. Call (949) 540-0320 to schedule a free initial consultation.
Frequently Asked Questions
How do you resolve a construction payment dispute?
Start with a formal written demand backed by complete documentation — contracts, change orders, invoices, and correspondence. If that fails, escalate through mediation or arbitration (check whether your contract requires ADR first), then to legal enforcement via mechanic's liens, stop payment notices, or bond claims based on project type and preserved notices.
What happens when a payment is disputed?
The disputing party withholds payment citing a reason — defective work, back charges, or contract breach. The unpaid party must assemble documentation, issue a formal demand, and act before statutory deadlines expire; waiting for resolution is the most common way claimants permanently lose their legal remedies.
How long can a payment be disputed?
The underlying contract dispute can drag on for years, but enforcement rights through a mechanic's lien or bond claim are strictly time-limited. In California, most subcontractors and suppliers must record a lien within 30 days of a recorded notice of completion and file a foreclosure lawsuit within 90 days of recording.
What is the difference between a mechanic's lien and a bond claim?
A mechanic's lien attaches to private property to secure an unpaid debt, while a bond claim is made against a surety's payment bond on public works projects — where placing a lien on public property is prohibited. Both are statutory remedies, but they apply in different project contexts and have different procedural requirements.
Do I need a lawyer for a construction payment dispute?
For any dispute involving significant amounts, approaching deadlines, a public works bond, or a non-responsive party — yes. Errors in notice, timing, or filing can permanently eliminate valid payment rights, and early legal involvement almost always costs less than losing a recoverable claim.
What are the deadlines for filing a mechanic's lien in California?
Direct contractors have 90 days after project completion or 60 days after a recorded notice of completion (whichever is earlier) to record a lien. Subcontractors and suppliers have 90 days after completion or 30 days after a recorded notice of completion — not 60. After recording, a foreclosure lawsuit must be filed within 90 days. Confirm your specific deadlines with a construction attorney, as project-specific circumstances can affect these windows.
